Tuesday, July 5, 2016

7-5-16

Controlling Operation Bartlett: Wall Construction
Controlling Operation Marion: PCCP Pavement
Controlling Operation Lasalle to Ewing: Removals
Fraction of Day workable 10/10
Hi 80 Lo 64
Weather Am Mostly Cloudy PM Mostly Cloudy

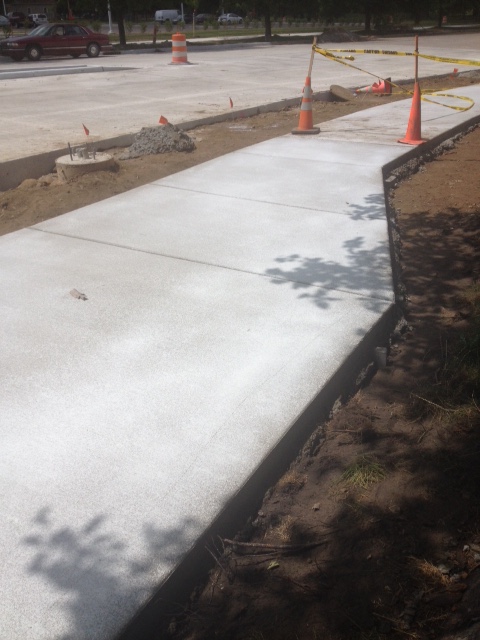

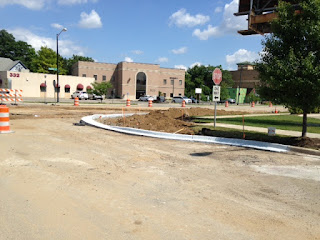

Rieth-Riley had a concrete crew at the Bartlett roundabout pouring 5" sidewalk at the northeast corner of the roundabout and the east side of Michigan north of the roundabout. Sidewalk was poured from Line E Sta. 71+36 to Line CC Sta. 18+23. Another concrete crew was pouring curb and gutter on Michigan between LaSalle and Madison. The west side of Michigan was completed from Linre PR-B Sta. 32+50 to 35+75 and around the bulb on the southwest corner of the Michigan/Madison intersection. The curb machine they were using had a sensor malfunction, and curb height variations were noticeable along the length of the curb on the west side of Main.

Rieth-Riley had an asphalt crew laying base at the intersection of Main and Marian from Line PR-D Sta. 60+00 to 62+00 and Line PR-A Sta. 22+50 to 17+00. The second lift of base was started in the afternoon.

Rieth-Riley also had a crew grading for concrete pavement at Main and Bronson.

Woodruff continued storm pipe work at the intersection of Main and Colfax. They ran pipe south from Str. 175A and capped the pipe at the south end of the intersection since they cannot complete the run until the work at Oyster Bar and Saigon Market has been completed.

Indiana Earth was grading on the west side of Main between LaSalle and Colfax. The also worked on removals on the west side of St. Joseph between Colfax and Washington.

Pemberton Davis was running conduit across Colfax on the west side of Main. Due to conflicts with the existing duct bank, the handhole scheduled for the northwest corner of the intersection would need to be placed in the bike path. It was determined that the handhole can be eliminated. They also palced a handhole on the corner of Main and Sample.

Ziolkowski continued setting formwork for the concrete walls of the Bartlett roundabout and informed Myron that they would not be pouring until Thursday (7/7).

No work was conducted in the Oyster Bar vaults today. The plumber rerouting the water line was instructed to coordinate with the Oyster Bar so the work can be conducted tomorrow (7/6).
